SmarteBuild
Winning the work

The lowest bid is usually the one that excluded the most

Comparing subcontractor prices is not arithmetic, it is checking they priced the same work. SmarteBuild sends one package to every trade, keeps a record of exactly what each of them received, and lays the bids side by side so the gaps are visible before you award anything.

Available on the Estimator plan and above

app.smartebuild.com.au/tenders

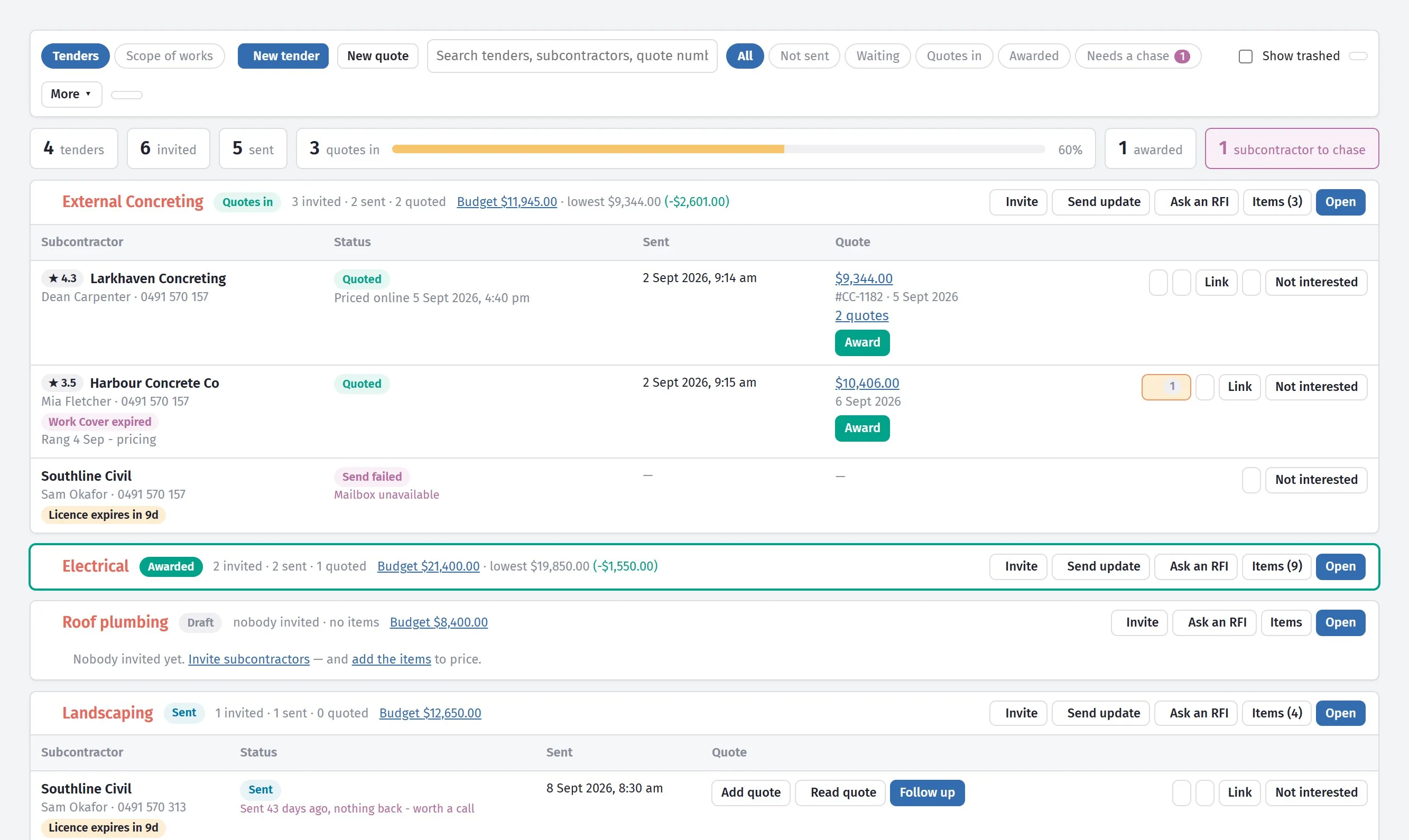

Every tender on the job: how many are invited, sent, quoted and awarded, with each subcontractor's status underneath.
Every package, and who has not come back to you.
One tender, several bids

A distinction that runs through the whole module

A tender is a package of work you send out for pricing. Each subcontractor you send it to gets a bid — their own copy, which they price and return.

Because they all come from the same package, they are comparable by construction. You are never trying to line up three PDFs that describe the scope three different ways.

What a tender carries

Items
The BOQ items the package covers
Recipients
The suppliers invited to price it
Attachments
Drawings, specifications, site information
Email
The subject and body sent with each invitation
Label and note
Your own reference, and internal notes
Comparing properly

The cheapest is not always the cheapest

Three bids for a roofing package. The one that looks cheapest is not, and the reason is not dishonesty — it is a subcontractor pricing exactly what they read.

What came back

BidderTotalNotes
A$17,240All items priced. Excludes scaffold.
B$18,600All items priced. Includes scaffold.
C$16,900 Sarking not priced. Excludes scaffold and edge protection.

C looks cheapest. Add the missing sarking at around $1,400 and C is $18,300 — and it still excludes edge protection.

Comparing like with like

Scaffold is $1,900 if you supply it. Put every bid on the same footing and the order changes:

BidderComparable total
A$19,140
B$18,600
C$20,200 + edge protection

B was the highest number on the page and is the cheapest bid.

app.smartebuild.com.au/tender

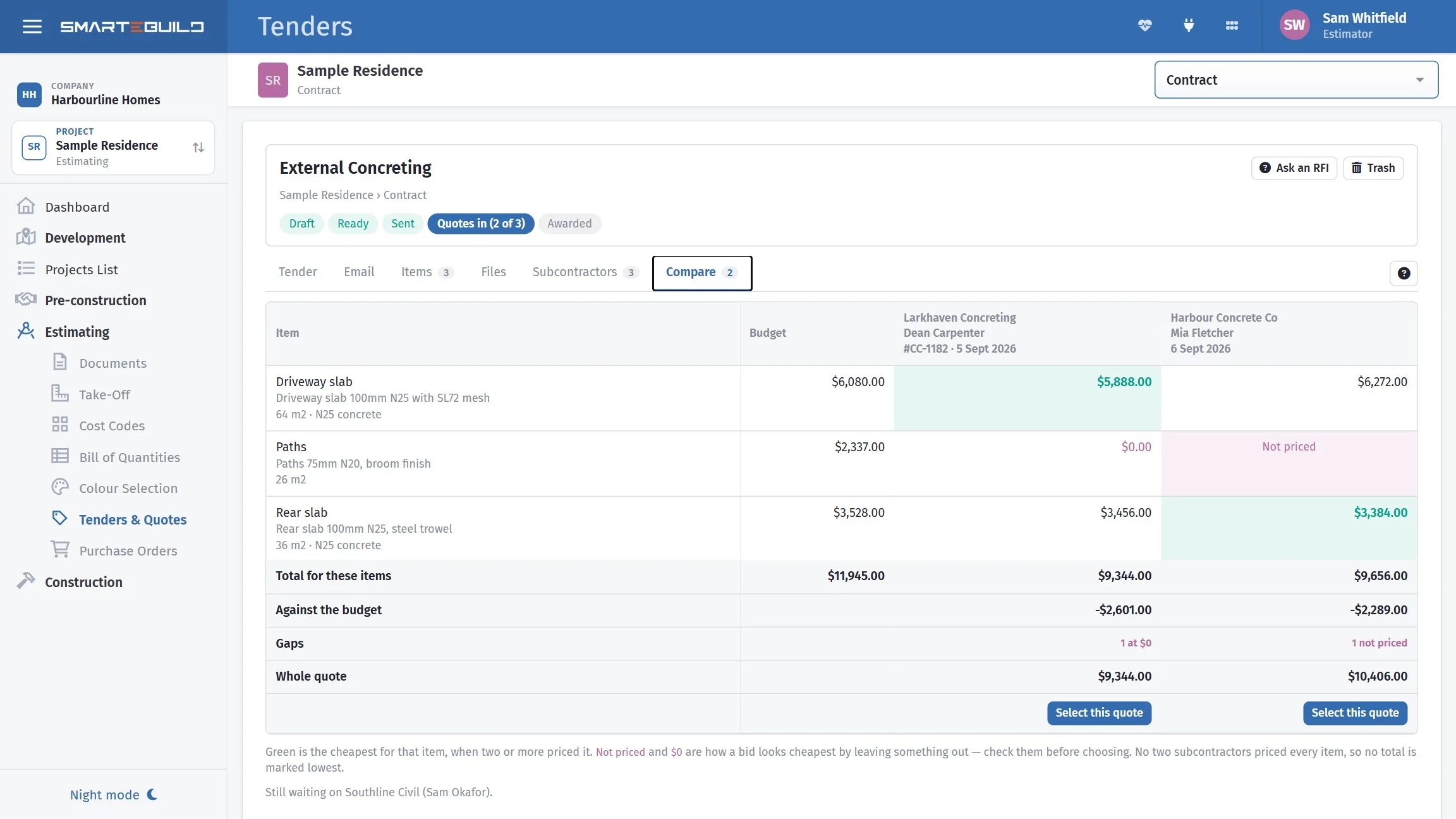

Two subcontractors' quotes beside the budget, line by line, with the cheapest price on each item in green.
Cheapest on two items, dearest overall — because of the one it left out.

Five things to check before you compare totals

Checks before comparing bids
CheckWhy
Every item priced?A gap makes a bid look cheap.
Exclusions?Read their document, not just the total.
Quantities as sent?A bidder who re-measured may have found something.
Conditions?Payment terms, retention, insurance, minimum call-outs.
Prelims and access?Scaffold, hoisting, cleaning — who is allowing for it.
The trail it leaves

“That is not what I priced”

Every bid records who was invited, what they were sent, when it went, and what came back. A price brought into the bill carries a Related bid link, so an item's rate can be traced to the subcontractor who quoted it and the package they were quoting at the time.

When that conversation happens six weeks later, the package they were sent is attached to the job — not sitting in somebody's sent items.

Awarding a quote picks up every line and can write them into the estimate in one go. If you award the wrong one, or the subcontractor pulls out a week later, the award can be undone and the estimate goes back to where it was — which is worth knowing before you press the button on a trade worth sixty thousand dollars.

Templates

Most builders send the same twelve packages on every job, and the covering email says the same thing every time. Save a tender's structure — the wording, the standard attachments, the recipient list — and load it on the next job.

Worth setting up early rather than on job five.

A closer look at tendering

Building the package, sending it, and knowing where each one got to.

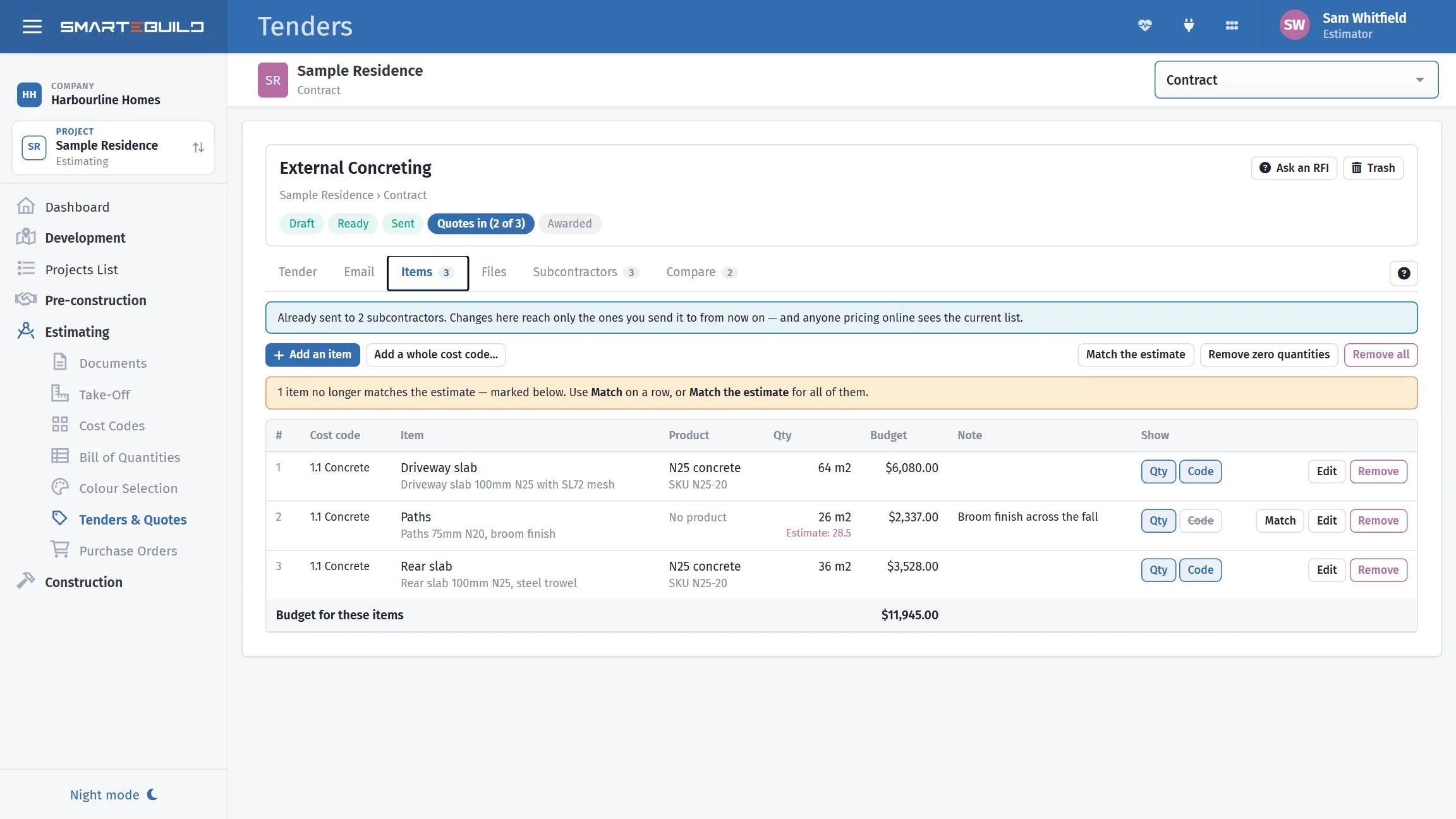

A tender package being built from BOQ items, with attachments and recipients.
The package, built from the bill

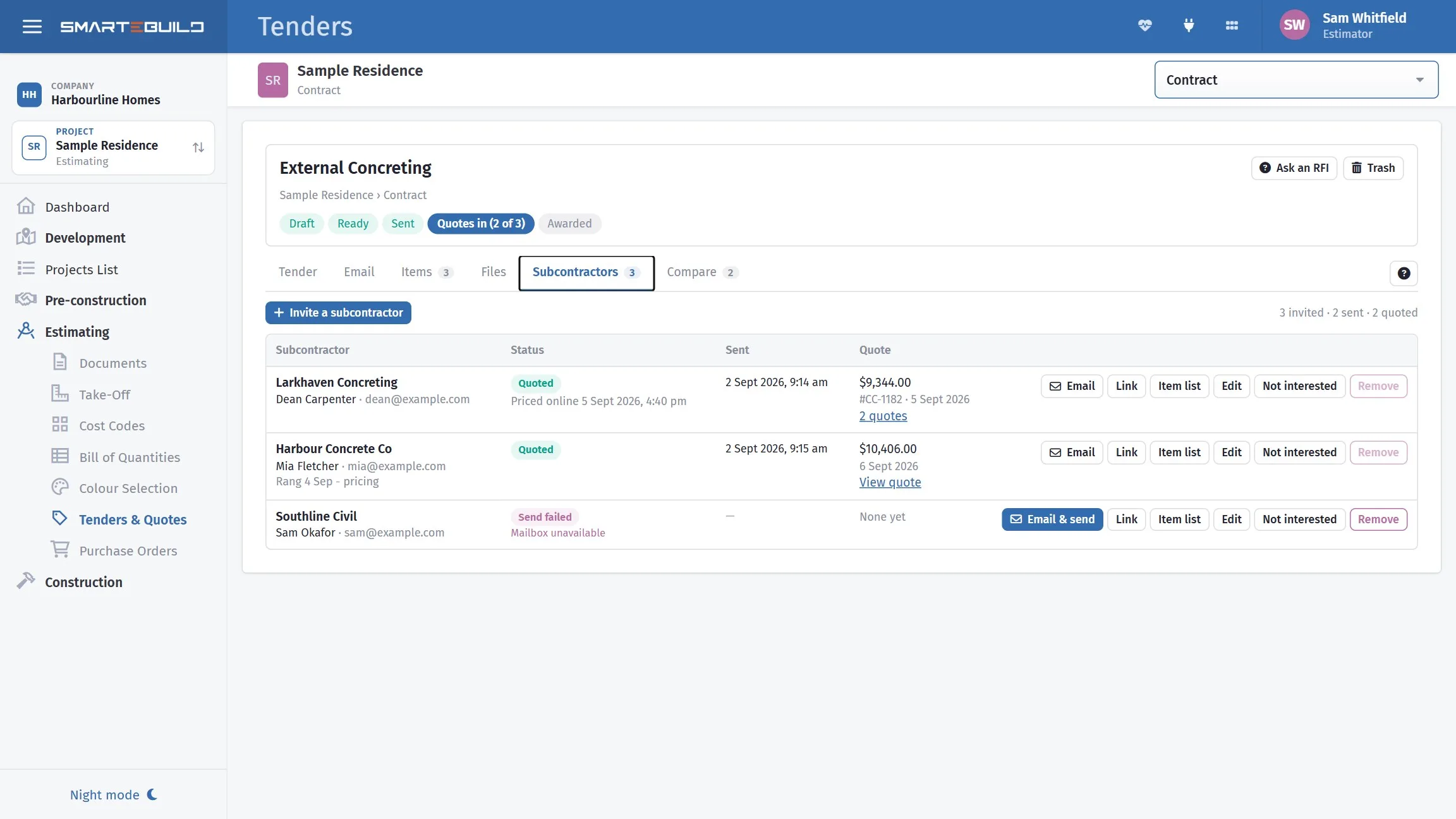

The tender list showing which subcontractors have been sent a package and which have responded.
Who has it, and who has replied

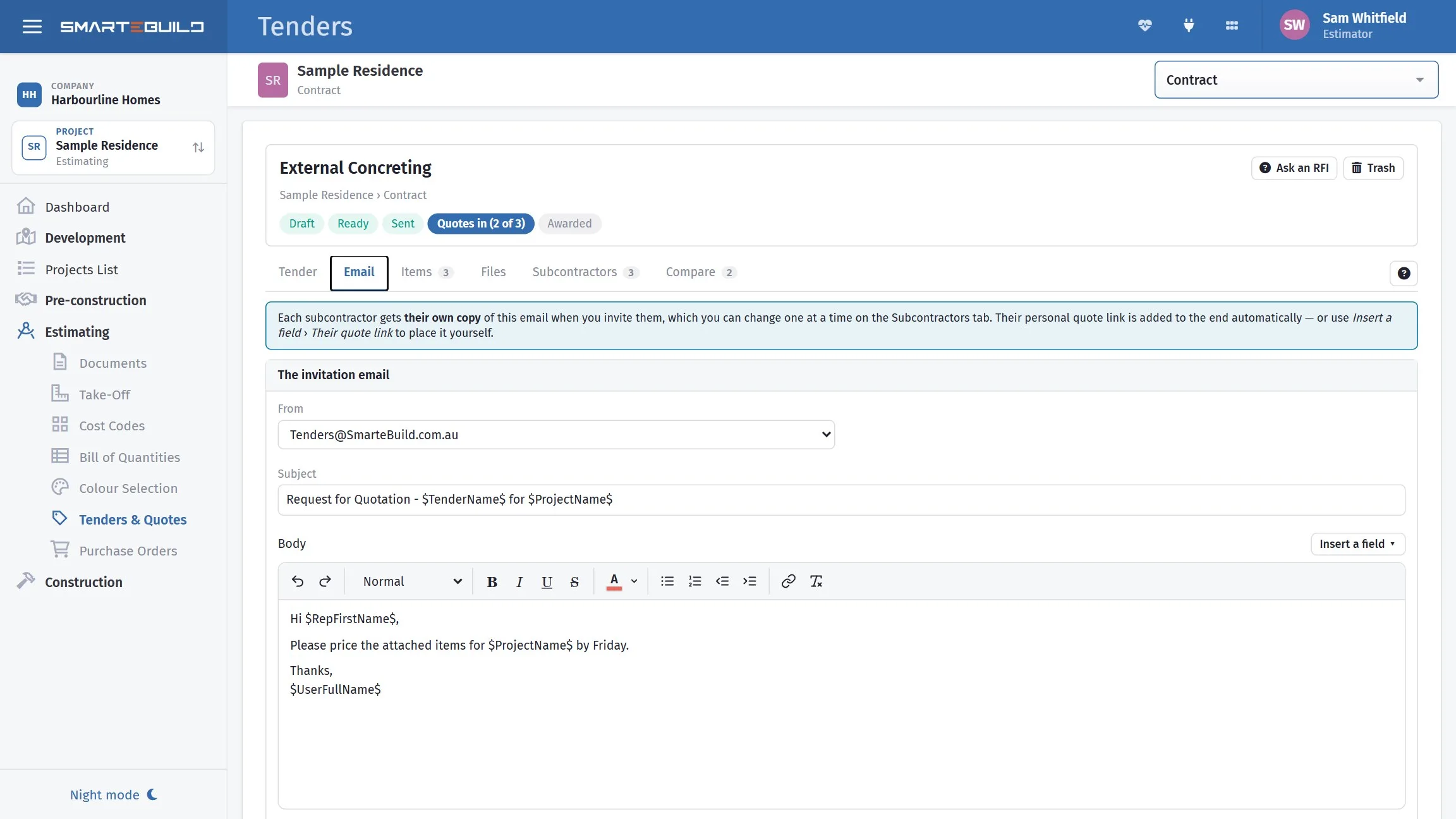

A saved tender template with its standard wording and attachments.
The same twelve packages, every job

What it connects to

Nothing in SmarteBuild is an island — that is the point of it. Tenders reads from and feeds into these.

  • Quotes Received

    Record what trades quoted and push the winner into the BOQ

  • Bill of Quantities

    The costed spine of the job — items, rates, markups and margin

  • Suppliers

    One supplier list across every job, with their products and rates

  • Purchase Orders

    Raise orders straight from the BOQ and send them without re-keying

Want the detail?

The help centre documents Tenders step by step, with worked examples — written for people using it, not for a brochure.

Start with one job and see
